How to Plan Custom AI Automation in 2026: A 5-Step Framework for Operations Leaders

TL;DR
- Most custom AI automation projects fail in planning: 95% of AI pilots deliver no measurable financial gain, and 46% of PoCs are scrapped before production.
- The cause of failure of AI automation projects is almost always picking the wrong use case, scoping too broadly, or skipping the build-vs-buy question.
- This guide gives operations leaders a 5-step framework, Scout, Score, Scope, Stack, Schedule, to plan custom AI automation before any code is written. It includes a Build-vs-Buy Decision Matrix, prioritization scoring, and a 30-day planning sprint you can run with your team next week.
Why custom AI automation is different from buying a platform
Global AI spending reached $2.52T in 2026, up 44% year over year, and AI-driven automation now accounts for 41% of all new technology investment. But the results of this spending aren’t satisfying: 95% of corporate AI pilots deliver no significant financial gain. Nearly every company is investing in automation, yet only 1% have fully integrated it into their workflows. Abandonment climbed to 42% of companies in 2025, up from 17% the year before, and 46% of AI proofs of concept are scrapped before they reach production.
Most custom AI automation projects fail due to poor planning. Companies have access to the same models, so what separates the winners is what they choose to build. Teams that stall often hit “AI strategy paralysis,” the state where tool volume and competing vendor pitches overwhelm them, leading them to abandon the effort.
Custom AI automation is the right choice when off-the-shelf platforms cannot fit your process. It earns its name only when off-the-shelf platforms can’t do the job. Power Automate, Zapier, UiPath, and Salesforce Agentforce cover a wide range of standard work, and most automation should run on these tools. The minority that shouldn’t share a few traits: complex business logic, proprietary processes, deep integration with legacy systems, data that can’t leave the premises, or processes that, when automated, create a competitive advantage. That’s the reader this guide serves, the one who already knows the shelf doesn’t fit and needs to go beyond off-the-shelf solutions.
The method below takes about 30 days of planning and ends with a fundable plan: a scored shortlist, a scoped MVP, a build-or-buy decision, and a budget with a kill date. If you’d rather run it with our engineers, start with an AI readiness assessment.

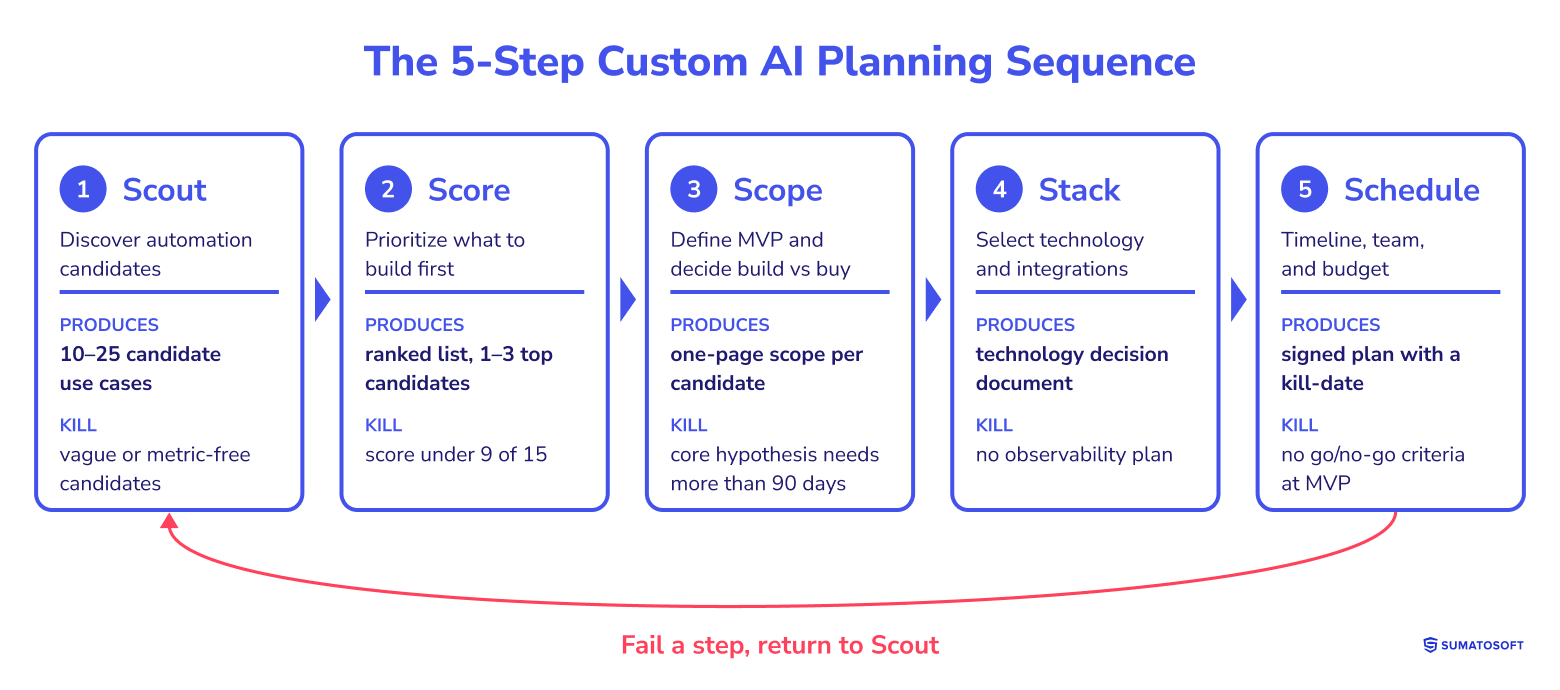

The 5-step custom AI planning sequence, at a glance

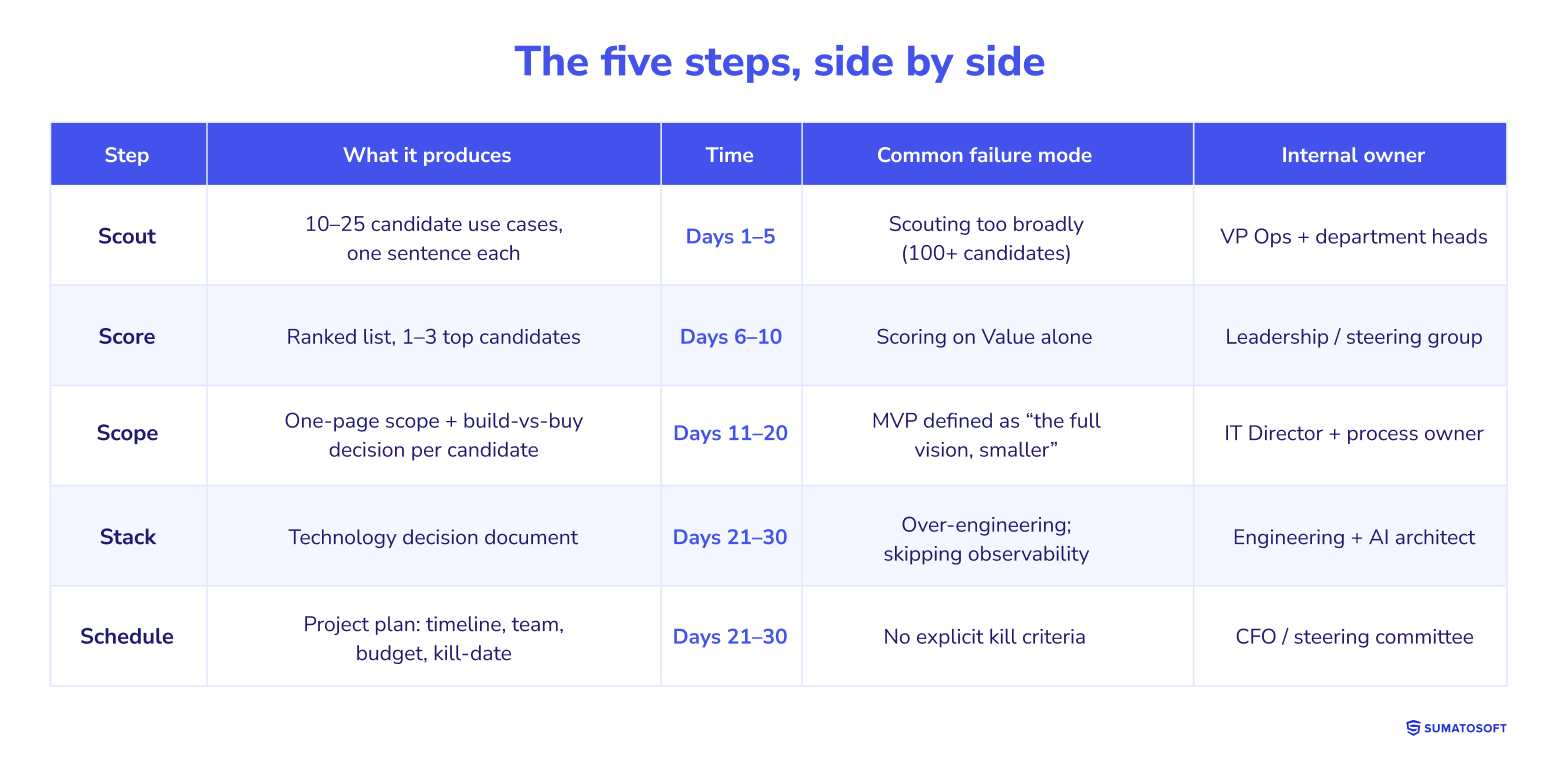

The five steps are Scout, Score, Scope, Stack, and Schedule, the five S’s. Each step produces one deliverable and includes a kill criterion that stops a weak candidate before it costs you. The sequence is iterative. If a candidate fails Score, it doesn’t advance to Scope; it goes back to Scout.

Step 1. Scout: discover automation candidates
What you produce
A list of 10 to 25 candidate automation use cases, each written in one sentence with a fixed template: “Reduce or increase [metric] in [process] by [target] using AI to [specific function].” For example, “Reduce contract review time in legal ops by 70% using AI to extract key terms,” or “Reduce SKU stockouts in warehouse ops by 40% using AI to forecast demand at the SKU level.” The template forces a metric and a target into every candidate, which makes the next step possible.
Know the three types of AI automation you’re scouting for

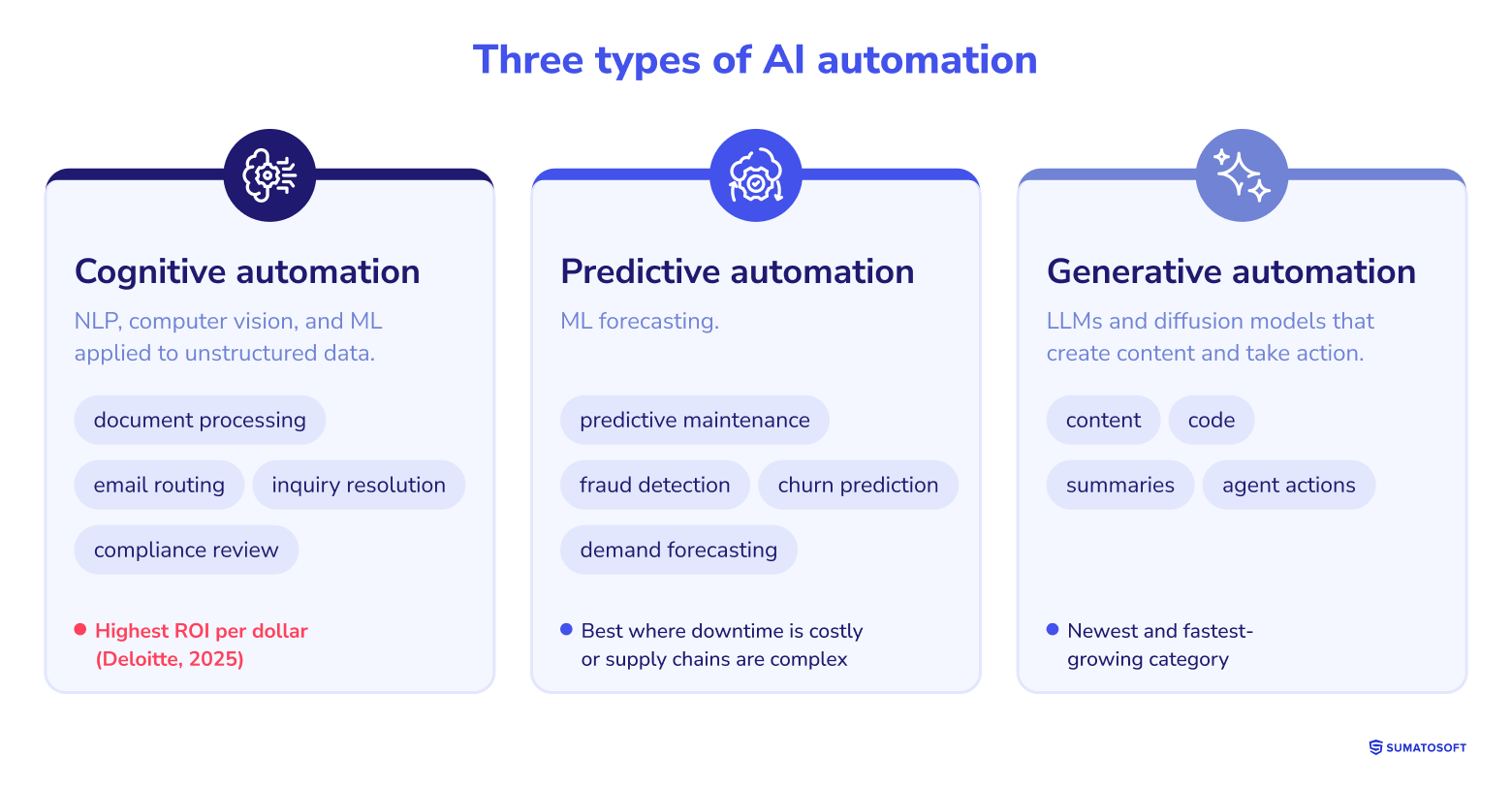

Sort each candidate into one of three categories. The type shapes how you’ll estimate cost and risk later.
- Cognitive automation applies NLP, computer vision, and machine learning to unstructured data: document processing, email routing, inquiry resolution, and compliance review. Deloitte’s 2025 Intelligent Automation research reports that it delivers the highest ROI per dollar among automation categories.
- Predictive automation forecasts from your own data: predictive maintenance, demand forecasting, churn prediction, and fraud detection. It pays off most in industries with expensive downtime or complex supply chains.
- Generative automation uses large language models and diffusion models to create content, write code, summarize, and take action. It’s the newest and fastest-growing category, and the one where scope creep starts.

How to do it
We recommend running three discovery channels in parallel.
- The process pain inventory is a round of interviews with department heads. The standard question is blunt: “What process do you hate, where people do something that a pattern could do?” Capture three to five candidates per department.
- The data-rich process scan finds processes that already generate digital data in your CRM, ERP, or ticketing systems. As we put it on our own machine learning development work, the reason a lot of ML pilots fail is that the data scientists couldn’t integrate their scripts with the legacy SQL databases the business actually runs on.
- The benchmark scan looks at what peers have automated, using sources like Forcoda’s 50 enterprise use cases, the McKinsey State of AI, and the Deloitte Intelligent Automation Survey. Where a candidate looks like a generative AI build, note it now.
Common failure mode at Step 1
The most common failure is scouting too broadly and walking out with 100+ candidates, which paralyzes Score. Enforce two constraints at intake: 1) each department contributes a maximum of five candidates, and 2) every candidate must reference a measurable metric. Vague entries such as “improve operations” or “enhance customer experience” get rejected on the spot.
Step 2. Score: prioritize what to build first
What you produce
A scored, ranked candidate list with one to three top candidates carried into Step 3. Scoring runs on a three-dimension rubric tuned to mid-market reality, and this is the step where you say no to unfeasible ideas. Killing weak candidates here is the discipline that protects the whole program, because AI projects compete for scarce specialists and limited board attention.
The scoring

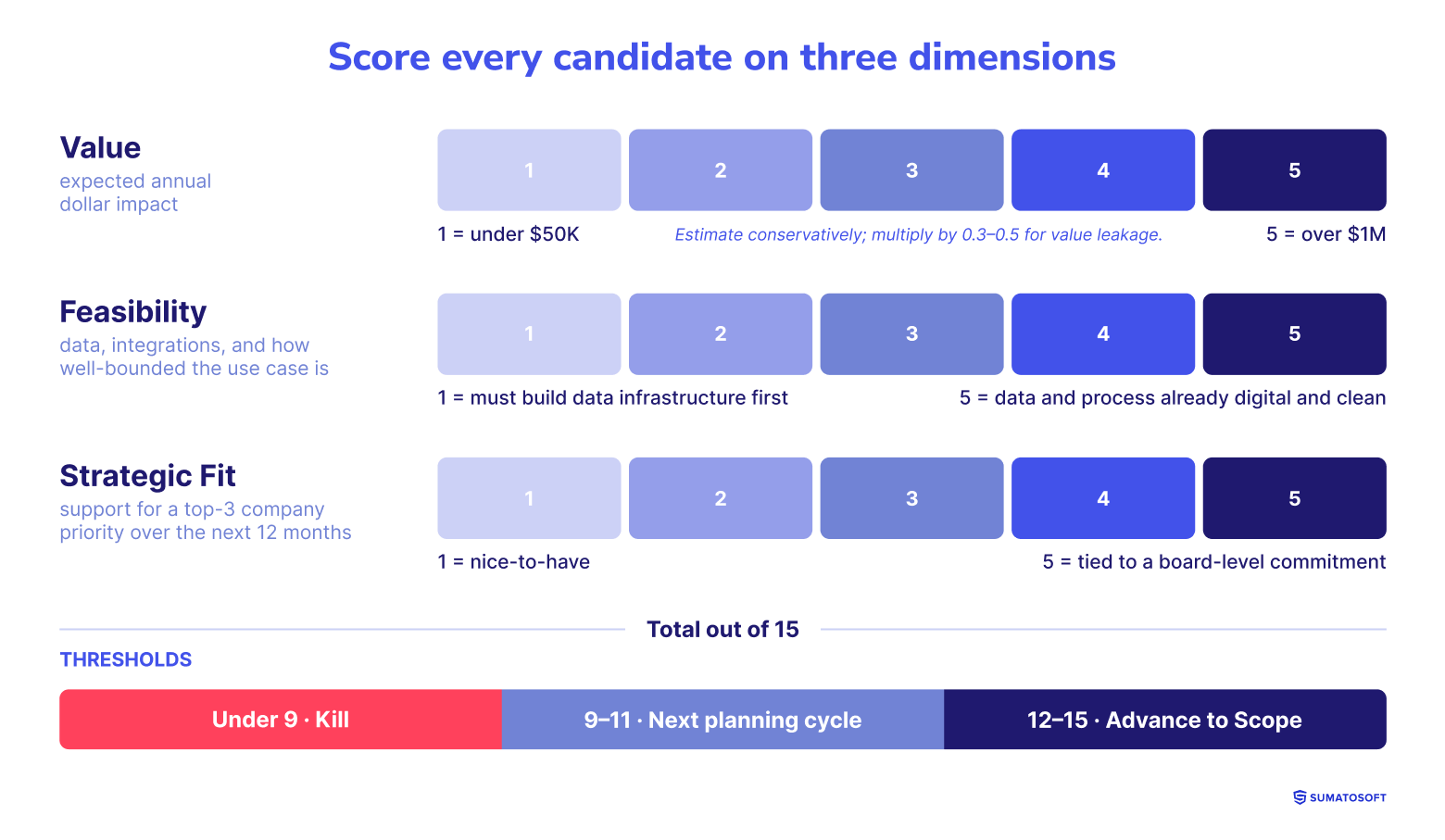

Score each candidate on three dimensions, 1 to 5, for a total of 15.
- Value (1–5) is the expected annual dollar impact, from 1 (under $50K) to 5 (over $1M). Estimate conservatively, then multiply by 0.3 to 0.5 to account for value leakage during implementation.
- Feasibility (1–5) asks whether the data and integrations are in place and whether the use case is well-bounded, from 1 (you’d have to build the data infrastructure first) to 5 (the data and process are already digital and clean).
- Strategic fit (1–5) measures support for a top-three company priority over the next 12 months, from 1 (nice-to-have) to 5 (tied to a board-level commitment).

Score every candidate against three dimensions: Value, Feasibility, and Strategic fit. Candidates scoring 12 or higher out of 15 advance to scoping. A candidate that scores 9 to 11 goes to the next planning cycle. Anything under 9 gets killed, and you don’t return to it until something material changes: new data, a new integration, or a new strategic priority. The common mistake is scoring solely on Value, which produces high-impact projects that can’t be delivered.
Why ICE and RICE alone do not work for custom AI
ICE (Impact, Confidence, Ease) and RICE (Reach, Impact, Confidence, Effort) work well for product features, but they underweight strategic fit. For custom AI, strategic fit matters more than it does for a routine product backlog, because AI builds draw on specialists and executive attention that a feature ticket never touches. The rubric here replaces “Confidence” with “Strategic fit.” Confidence still lives inside Feasibility and Value, which you estimate conservatively to absorb the uncertainty.
Step 3. Scope: define MVP and decide build vs buy
What you produce
A one-page scope document for each top candidate that states the MVP (the smallest version that proves value), the build-vs-buy decision with its justification, success criteria with measurable thresholds, and explicit exclusions that name what the MVP will not do.
MVP definition for custom AI
The MVP test for custom AI is a single question: can you prove the core hypothesis in 90 days within the PoC tier ($10K to $30K for a focused proof, scaling to $100K+ for a production build)? If you cannot prove the core hypothesis in 90 days within the PoC tier, your scope is too big, cut features until you can. Three reduction patterns get you there:
- Process subset. Instead of a contract review across all contract types, start with NDAs only.
- Volume subset. Instead of all 10,000 monthly requests, start with the top 200 by frequency.
- Feature subset. Instead of full agent autonomy, start with AI-assisted human review, keeping a person in the loop.
When a candidate points toward generative models, our AI proof-of-concept development work is scoped the same way, around one hypothesis and one measurable threshold.
The build vs buy decision matrix

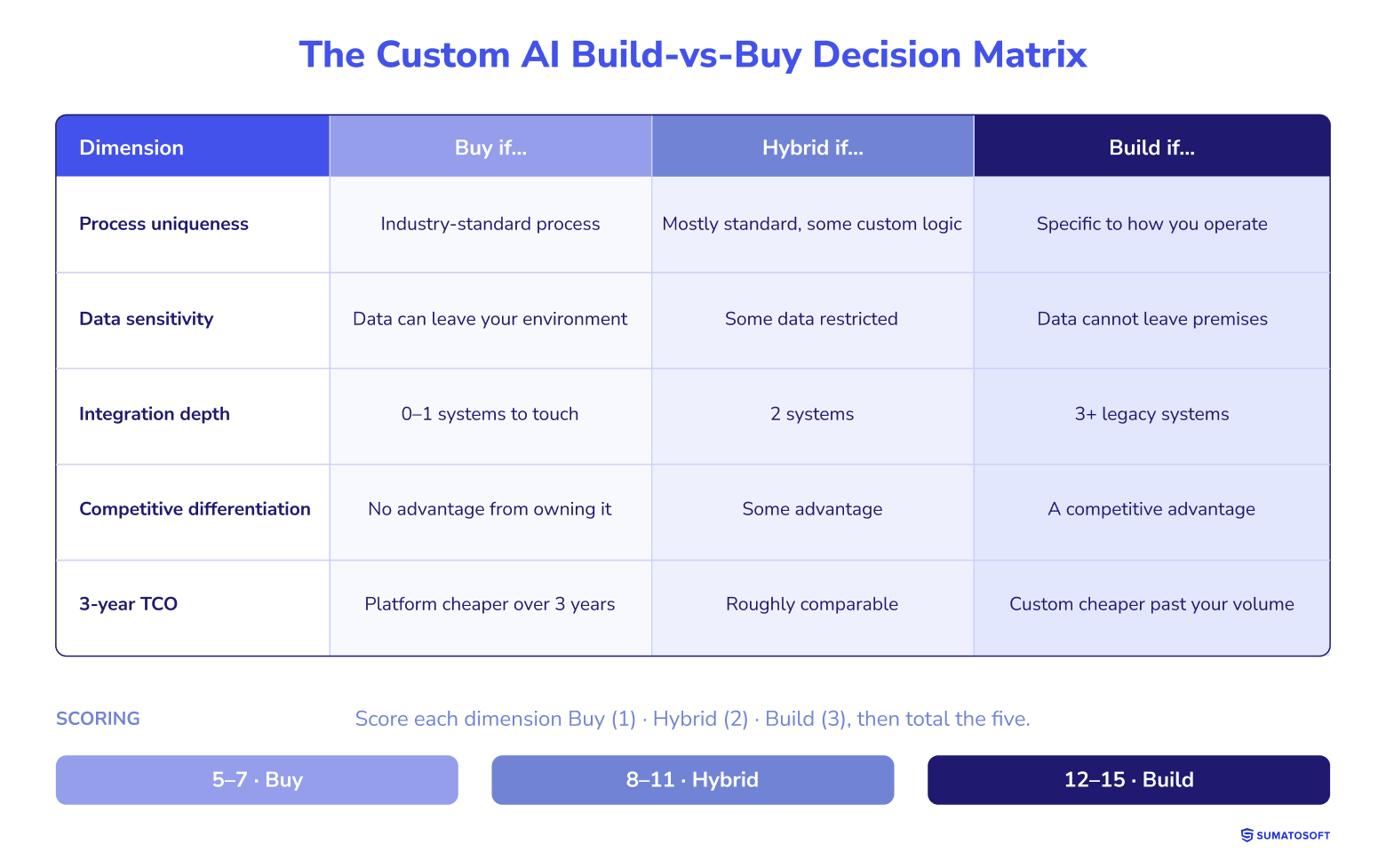

Score each candidate on five dimensions to decide whether to buy a platform, build custom, or take a hybrid path.
- Process uniqueness. Standard across your industry points to buy; specific to how you operate points to build.
- Data sensitivity. If data can leave your environment, buy is open; if it can’t, build or self-host.
- Integration depth. Zero or one system points to buy; three or more legacy systems usually make custom integration win.
- Competitive differentiation. No advantage from owning it points to buy; a real advantage points to build.
- 3-year TCO. Compare a platform license across three years against a custom build amortized over the same period. Past a certain volume, custom wins.
Score each dimension Buy (1), Hybrid (2), or Build (3). A total of 5 to 7 says buy, 8 to 11 says hybrid, and 12 to 15 says build. Once you have a signed scope, the actual building process follows a defined lifecycle. SumatoSoft runs the Agentic Development Lifecycle (ADLC) alongside standard SDLC, a 7-phase framework for governed AI development.
Step 4. Stack: select technology and integrations
What you produce
A technology decision document covering model selection, infrastructure, the data layer, integration patterns, and security architecture. This is the document an engineering team needs to begin Phase 3 of ADLC – Secure Architecture Design.
The 5 stack decisions
Each decision has a sensible default for a mid-market context.
- Model selection. Use frontier models (Claude, GPT-4-class) for complex reasoning, and smaller or open-source models (Llama, Mistral, Haiku, GPT-4o-mini) for high-volume routine tasks, with tiered routing where both apply. Our AI cost reduction playbook covers the routing logic.
- Infrastructure. Cloud-managed services (Bedrock, Azure OpenAI, Google Vertex) fit most cases. Self-host only when data sovereignty requires it or volume justifies the operational overhead.
- Data layer. A vector database (Pinecone, Weaviate, pgvector) handles retrieval, and business systems connect through REST or GraphQL APIs and message queues.
- Integration patterns. Go API-first with idempotent design. Avoid screen scraping and brittle UI automation whenever possible.
- Security architecture. Encrypt data in transit and at rest, enforce role-based access control, and log for audit. For regulated work, design to ISO 27001 from day one. SumatoSoft is an ISO 27001 and ISO 9001-certified AI development company, aligned with GDPR and the EU AI Act, and we build it in rather than bolt it on. Custom ML builds run through our custom machine learning development practice under the same controls.
Common stack mistakes
Three patterns cause most of the pain: the first is over-engineering the stack at the MVP stage; pick the simpler option until it proves inadequate; the second is vendor lock-in with no exit plan; every model choice should have a fallback path; the third is skipping observability. Models degrade the second they go live, and without logging, tracing, and drift detection from day one, you can’t debug the system, optimize it, or prove its ROI.
Step 5. Schedule: timeline, team, and budget
What you produce
A project plan with a timeline (typically 12 to 24 weeks for a first MVP), a team, a budget with contingency, and an explicit kill date with go/no-go criteria at MVP completion.
Typical custom AI economics

We frame budgets into three tiers:
- PoC or focused proof: $10K to $30K. A bounded proof of concept that validates the core hypothesis on a slice of a process.
- Production MVP: $25K to $100K. The range is driven by the complexity of integrations and data work, far more than by the AI models themselves.
- Full-scale AI product: $100K to $500K and up. Enterprise-grade systems with deep integration, custom models, and production governance.
Recurring cost after launch (compute, monitoring, and ongoing tuning) runs about 1% to 2% of build cost per month. And you should budget 20% to 30% of the total automation investment for data cleansing and integration, the work that most projects underestimate, according to research.

Team composition
A typical team for a custom AI MVP runs seven to ten people, of whom only three to six are full-time on the build. On the internal side, you need a product or process owner, an IT or engineering point of contact, and a data subject-matter expert from the business. On the partner side, you need an AI architect, one or two AI/ML engineers, a backend engineer, a data engineer, and a designer if the system is user-facing. Our “Dual-Engine” model pairs the data scientists who build models with the software engineers who build applications, which closes the integration gap that kills most ML pilots.

The custom AI build-vs-buy decision matrix

Score each dimension Buy (1), Hybrid (2), or Build (3), and total the five. A 5 to 7 says buy, a 8 to 11 says hybrid, and a 12 to 15 says build. Most processes should be platform-based, while custom is the exception. Even across our own engagements, a meaningful share of automation candidates end up as platform-purchase recommendations rather than custom builds.
7 common planning mistakes (and how to avoid them)
- Starting with the technology, not the process. “We should use LLMs somewhere” is not a plan; “this process is broken, and AI could fix it” is.
- Scoring on Value alone. Ignoring Feasibility and Strategic Fit produces high-impact projects that can’t be delivered.
- Defining the MVP as “the full vision, smaller.” The MVP is the smallest version that proves the hypothesis, and calling the whole build a smaller vision quietly commits you to all of it.
- Skipping the build-vs-buy question. Defaulting to custom because you have engineers, or to buy because vendors keep calling, both skip the analysis.
- Treating data preparation as a separate project. Most AI projects fail at the data layer, so budget 20% to 30% for data work within the AI project, not as a prerequisite owned by someone else.
- No explicit kill criteria. Pilots without decision points drift for 12 months or more and quietly consume the budget.
- Planning AI without planning observability. Models degrade the second they go live, and without logging, tracing, and evaluation from day one, you can’t debug or optimize.
Your 30-day custom AI planning sprint

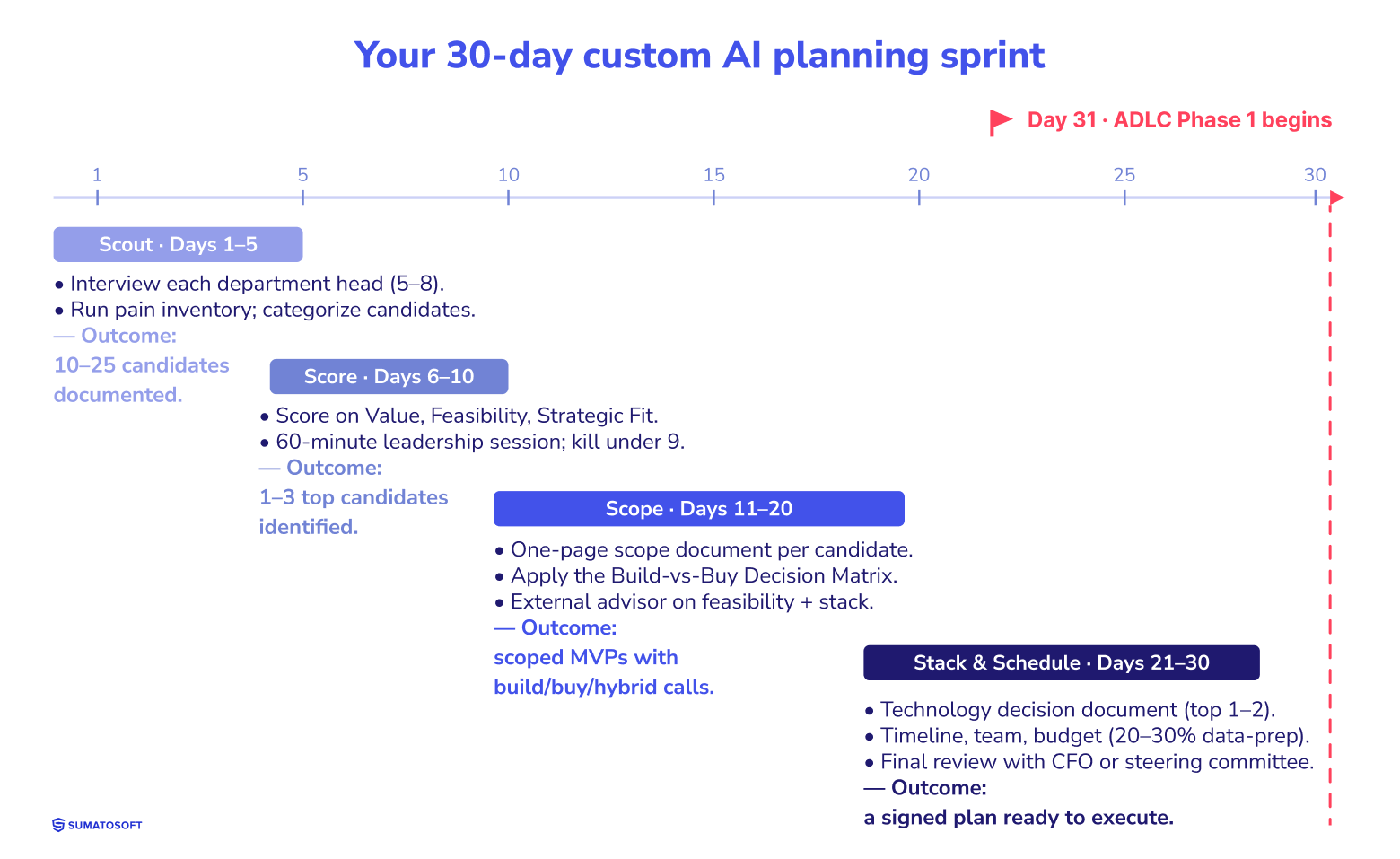

Here is the whole method for one month that can be run with a small team.
Days 1 to 5. Scout. Book 30-minute interviews with each department head, five to eight in all, and run the process pain inventory using the standard template, sorting each candidate into one of the three automation types. End the week with 10 to 25 candidates in a shared spreadsheet.
Days 6 to 10. Score. Score each candidate on Value, Feasibility, and Strategic Fit for a total out of 15, review them in a single 60-minute leadership session, and kill everything under 9. End with one to three top candidates.
Days 11 to 20. Scope. Write a one-page scope for each survivor, apply the build-vs-buy matrix, and bring in an external technical advisor, such as an AI readiness assessment, for a second read on feasibility and stack. End with scoped MVPs, each carrying a build, buy, or hybrid decision.
Days 21 to 30. Stack and schedule. Write the technology decision document for the top one or two candidates, draft the timeline, team, and budget with the 20% to 30% data-prep allocation built in, and take it to the CFO or steering committee. End with a signed plan. ADLC Phase 1 begins on day 31.

Tools and resources for AI automation planning
These are tools for the planning phase. You can run every step above with a spreadsheet, and the tools below mostly help you do it faster.
| Planning job | Options |
| Use-case discovery | Process mining (Celonis, Apromore), typically enterprise, or structured interview templates for smaller orgs |
| Prioritization | Any scoring template that captures the three-dimension rubric; a shared spreadsheet works |
| Scoping | A standard one-page scope template |
| Build vs buy | This guide’s Decision Matrix |
| Reference frameworks | Microsoft Cloud Adoption Framework for AI, NIST AI Risk Management Framework, EU AI Act risk categories |
SumatoSoft is vendor-neutral; this section names tools we have encountered across client engagements, not products we resell.
Frequently asked questions
How do I plan custom AI automation?
Run five steps before you build: Scout candidates from your teams, Score them on Value, Feasibility, and Strategic Fit, Scope the top one to three into one-page MVPs, choose your Stack, and Schedule a plan with a budget and a kill date. Budget about 30 days for the planning itself.
When should we build custom AI instead of buying a platform?
Build when off-the-shelf tools can’t fit the process: unique business logic, data that can’t leave your environment, three or more legacy integrations, or a real competitive advantage. Score the five build-vs-buy dimensions; a total of 12 to 15 points to build, and most processes score lower and should be bought.
How much does a custom AI automation project cost?
A focused proof-of-concept runs $10K to $30K, and a full-scale AI product runs $100K to $500K and up. Plan for recurring cost of roughly 1% to 2% of build cost per month, and set aside 20% to 30% of the total for data cleansing and integration.
How long does it take to plan and launch custom AI automation?
Planning takes about 30 days using the sprint in this guide. A first MVP build then typically runs 12 to 24 weeks, depending on integration depth and how clean the data is at the start.
Who should own AI automation planning internally?
Operations or the automation P&L owner leads it, with IT or engineering as a close partner. Scoring belongs to the leadership group, and the final plan goes to the CFO or a steering committee, since the kill date and budget are their decisions to sign.
What is the biggest reason custom AI projects fail?
Planning, not technology. Teams pick the wrong use case, scope the MVP too broadly, skip the build-vs-buy question, or underestimate the data work. The failure shows up during the build, but the cause is a decision made before it.
Do we need an AI strategy before we start planning automation?
No. A short list of process candidates and this five-step method are enough to start. Strategic fit is scored into every candidate, so the planning itself surfaces which automation supports your real priorities without a separate strategy document.
Conclusion: planning is what separates AI pilots from AI programs
The distance between the 5% of AI projects that deliver value and the 95% that don’t is almost entirely upstream of the build. It’s in how the team chose what to build, how they scoped it, how they decided build versus buy, and how tightly they bound the first MVP.
SumatoSoft has delivered 350+ custom products over 14+ years, with a 98% client satisfaction rate and clients in 26 countries, and the planning mistakes repeat across almost all of them. This 5-step planning sequence is the frontend of the Agentic Development Lifecycle, the framework SumatoSoft runs alongside standard SDLC across all custom AI engagements.
If there’s a line worth drawing in 2026, it’s between companies that keep experimenting with AI and companies that operationalize it, and planning discipline is what puts you on the right side of it. For the methodology that picks up where this guide ends, read what ADLC is and how its 7 phases work, or explore custom AI software development.
Let’s start
